Why metrics
What to consider for agile metrics
Various examples
1
1Montag, 22. April 13
Why
2
2Montag, 22. April 13

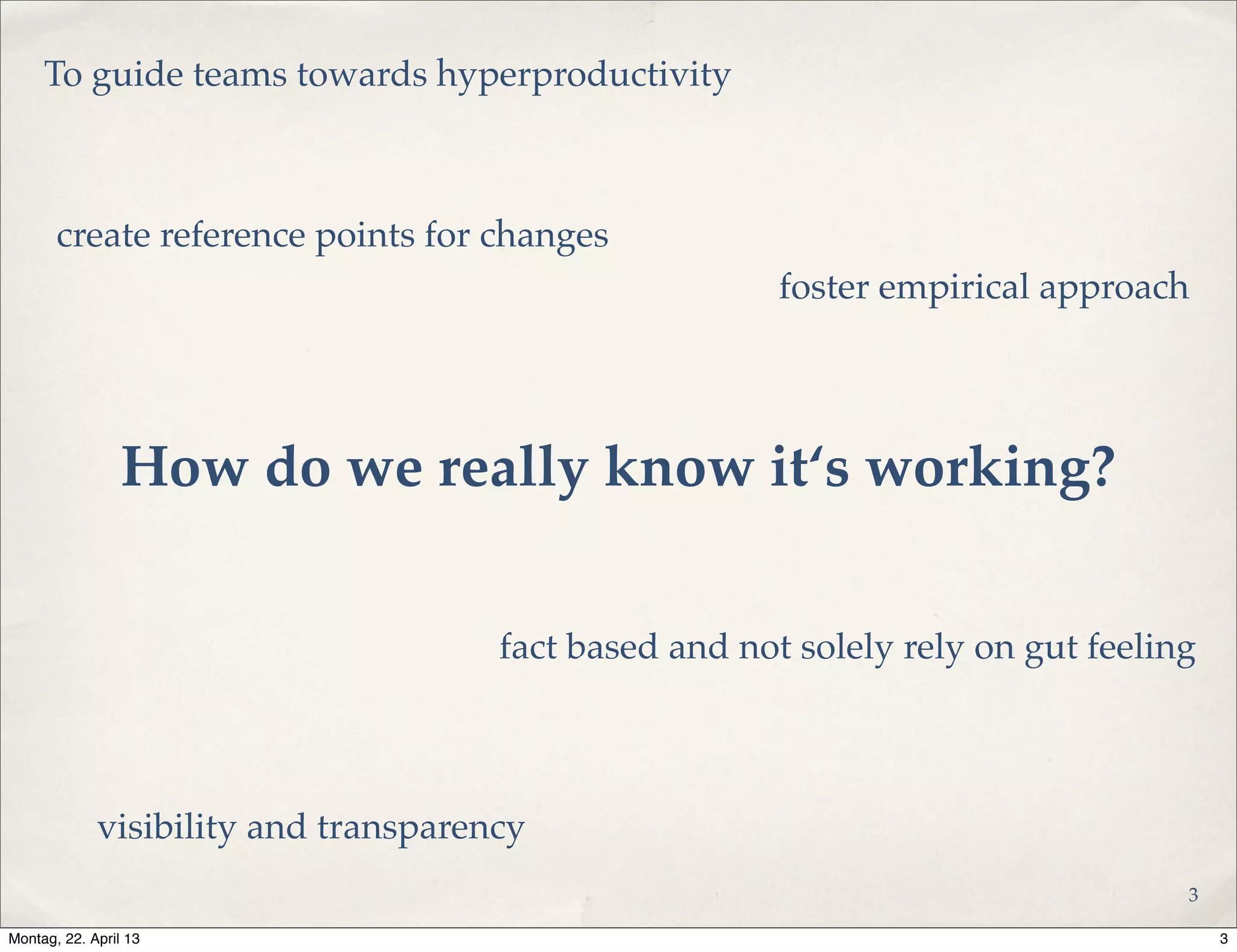

To guide teams towards hyperproductivity
create reference points for changes
foster empirical approach
fact based and not solely rely on gut feeling
visibility and transparency
How do we really know it‘s working?
3
3Montag, 22. April 13
4
4Montag, 22. April 13
What to consider for agile metrics
VersionOne, Inc. [CC-BY-SA-3.0 (http://creativecommons.org/licenses/by-sa/3.0)], via Wikimedia Commons
5
5Montag, 22. April 13

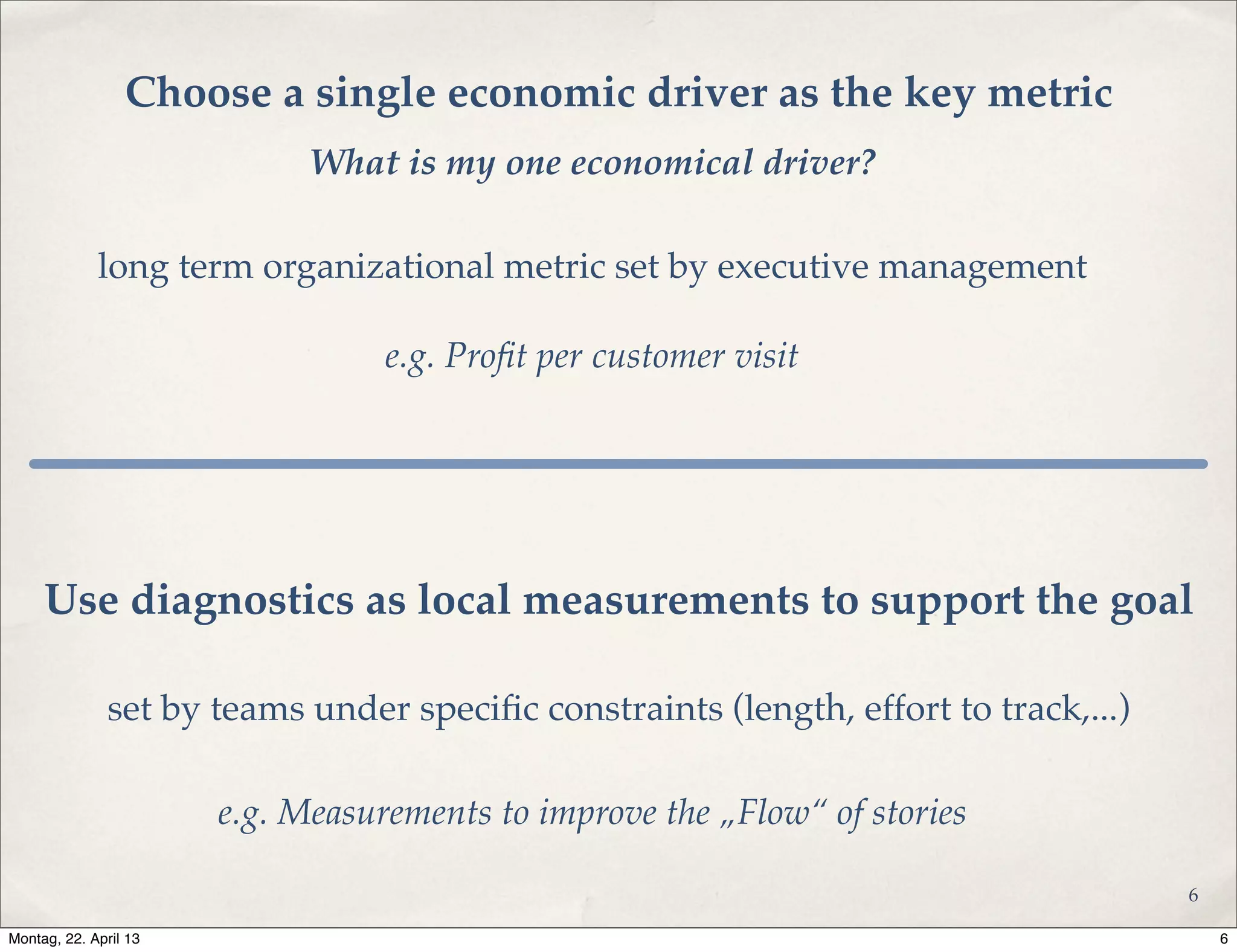

Choose a single economic driver as the key metric
e.g. Profit per customer visit
long term organizational metric set by executive management
Use diagnostics as local measurements to support the goal
set by teams under specific constraints (length, effort to track,...)
e.g. Measurements to improve the „Flow“ of stories
What is my one economical driver?
6
6Montag, 22. April 13
A good agile Metric or
Diagnostic ...
7
7Montag, 22. April 13

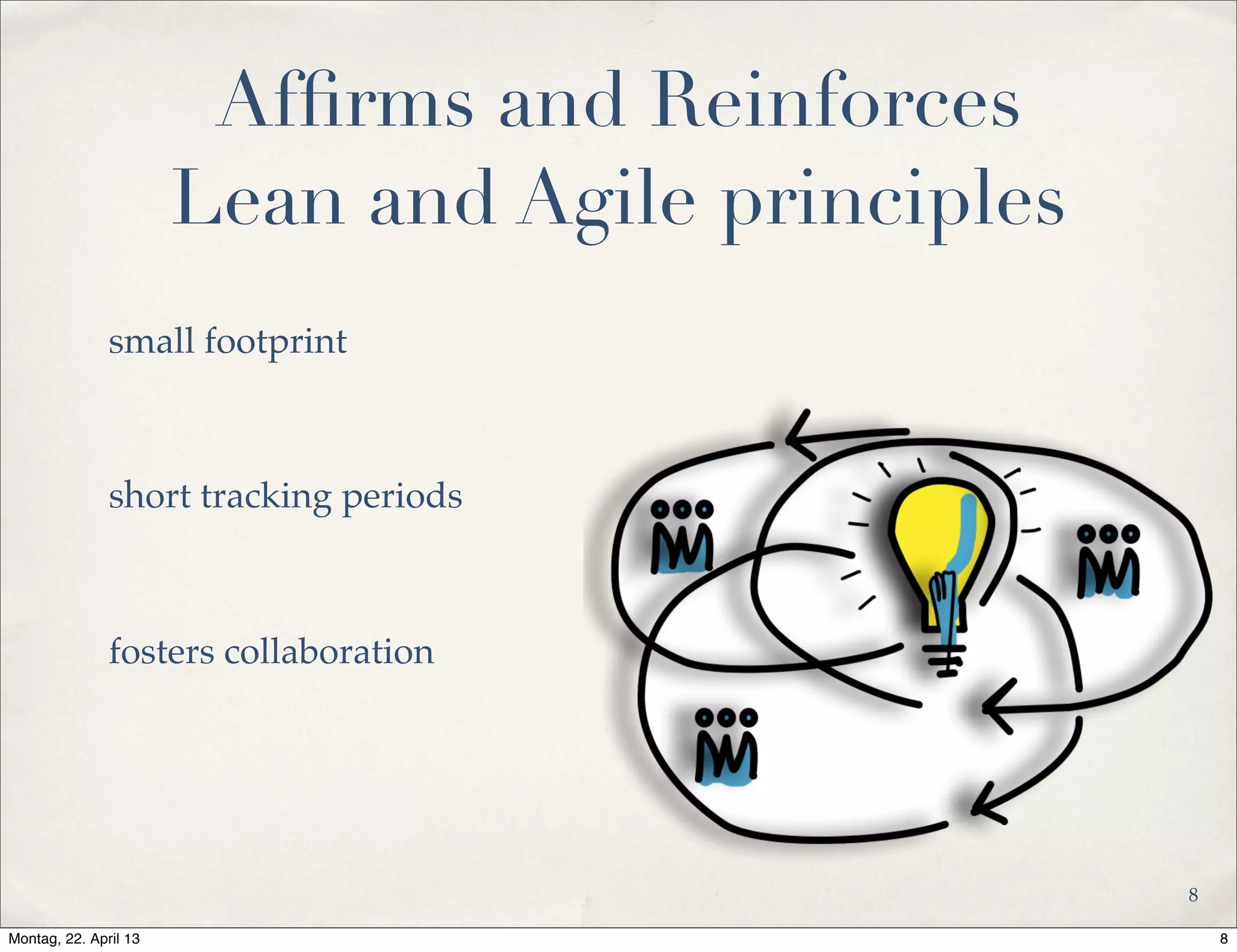

Affirms and Reinforces
Lean and Agile principles
small footprint
short tracking periods
fosters collaboration
8
8Montag, 22. April 13

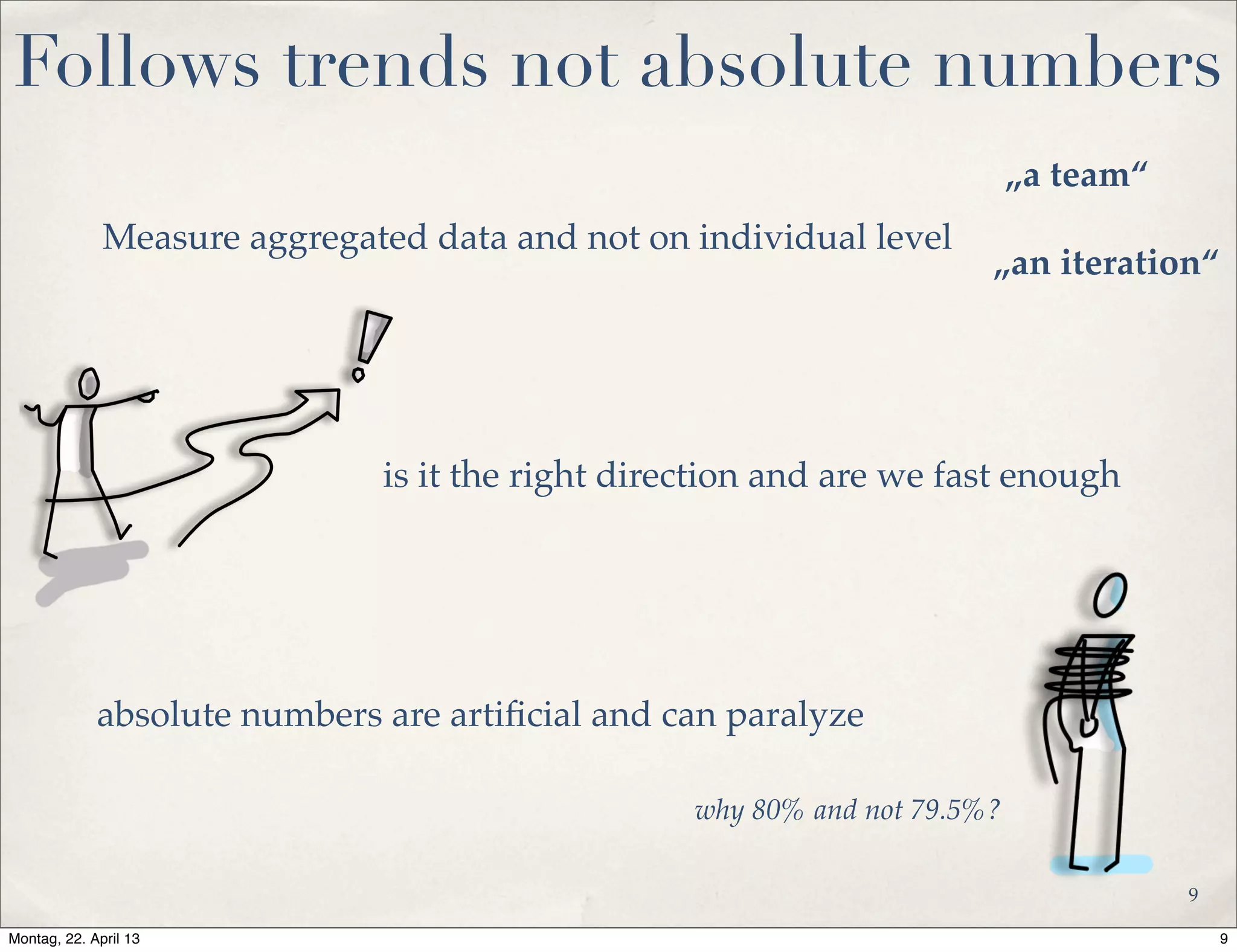

Follows trends not absolute numbers
Measure aggregated data and not on individual level
„a team“
„an iteration“
is it the right direction and are we fast enough
absolute numbers are artificial and can paralyze
why 80% and not 79.5%?
9
9Montag, 22. April 13

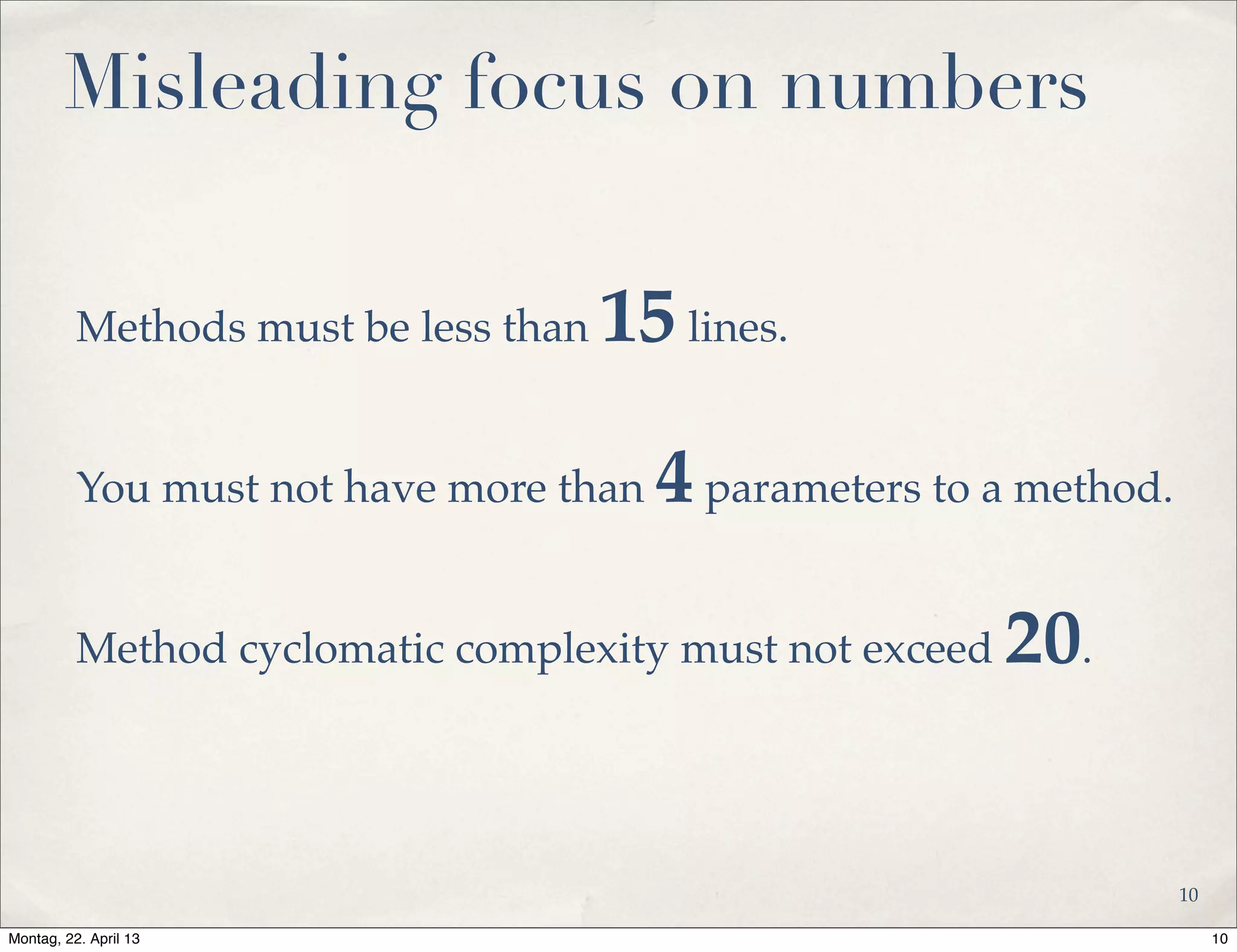

Misleading focus on numbers
Methods must be less than 15lines.
You must not have more than 4parameters to a method.
Method cyclomatic complexity must not exceed 20.
10
10Montag, 22. April 13

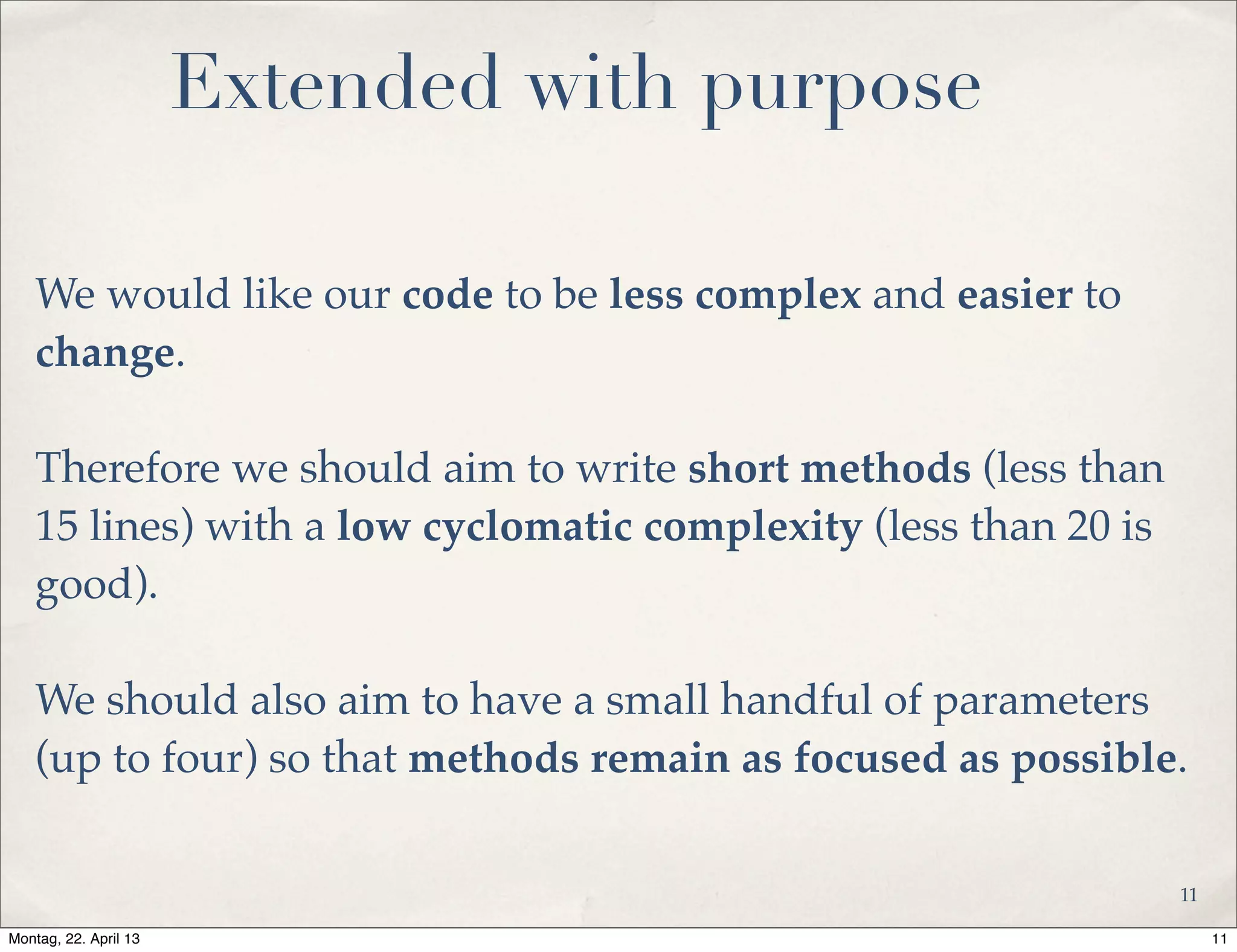

Extended with purpose
We would like our code to be less complex and easier to
change.
Therefore we should aim to write short methods (less than
15 lines) with a low cyclomatic complexity (less than 20 is
good).
We should also aim to have a small handful of parameters
(up to four) so that methods remain as focused as possible.
11
11Montag, 22. April 13

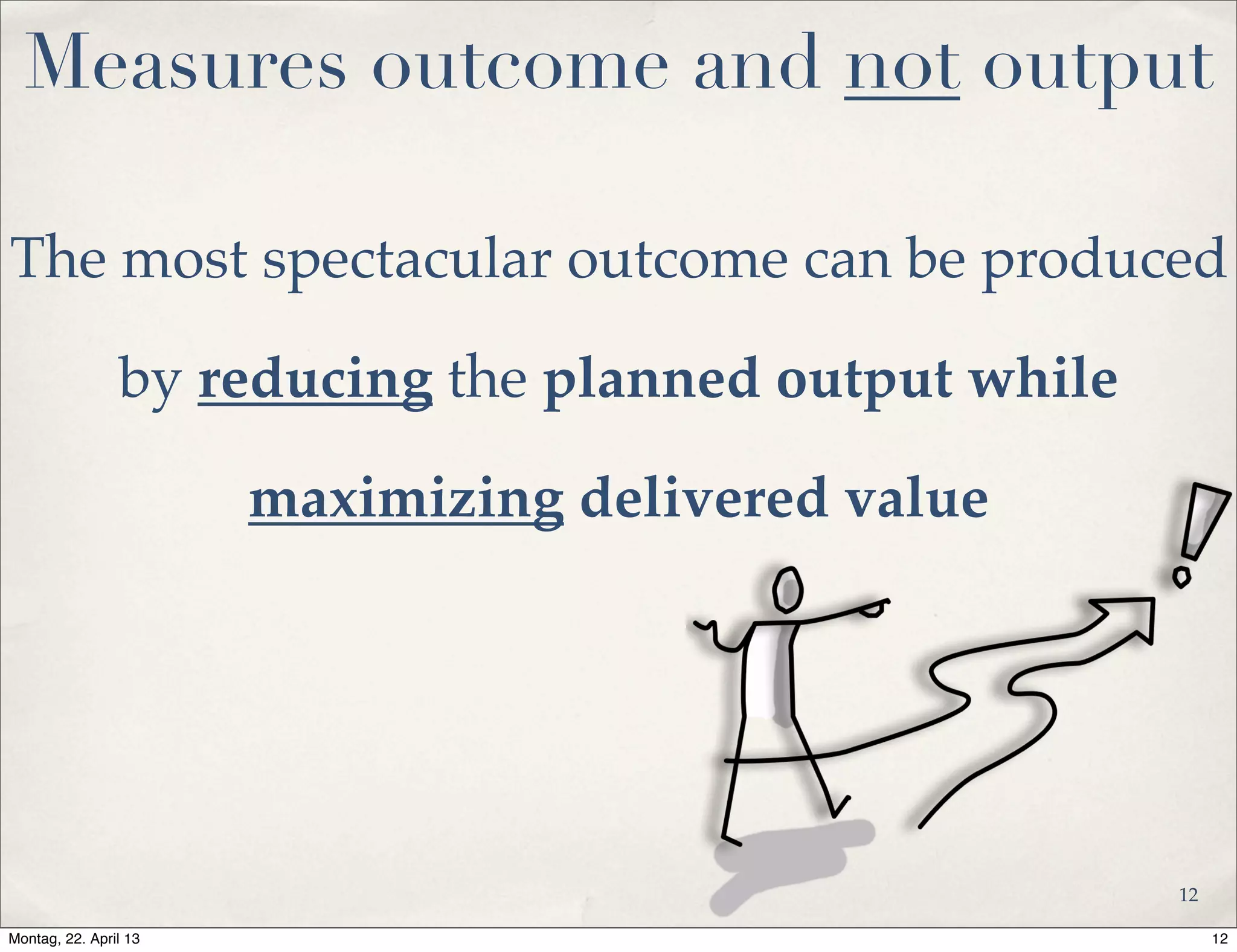

Measures outcome and not output
The most spectacular outcome can be produced
by reducing the planned output while
maximizing delivered value
12
12Montag, 22. April 13
Easy to collect
One button automation ...
Drawn from operational tools
(Backlog, Acceptance Test Suite, Code Analyzers)
Easy aggregation and avoidance
of management rework
13
13Montag, 22. April 13
Provides fuel for meaningful
conversation
It‘s a good sign if people talk
about what they‘ve learned
to amplify learning and accelerate process improvement
14
14Montag, 22. April 13
Provides feedback on a frequent
and regular basis
available in each iteration retrospective and
to amplify learning and accelerate process improvement
key periodic management meeting
15
15Montag, 22. April 13

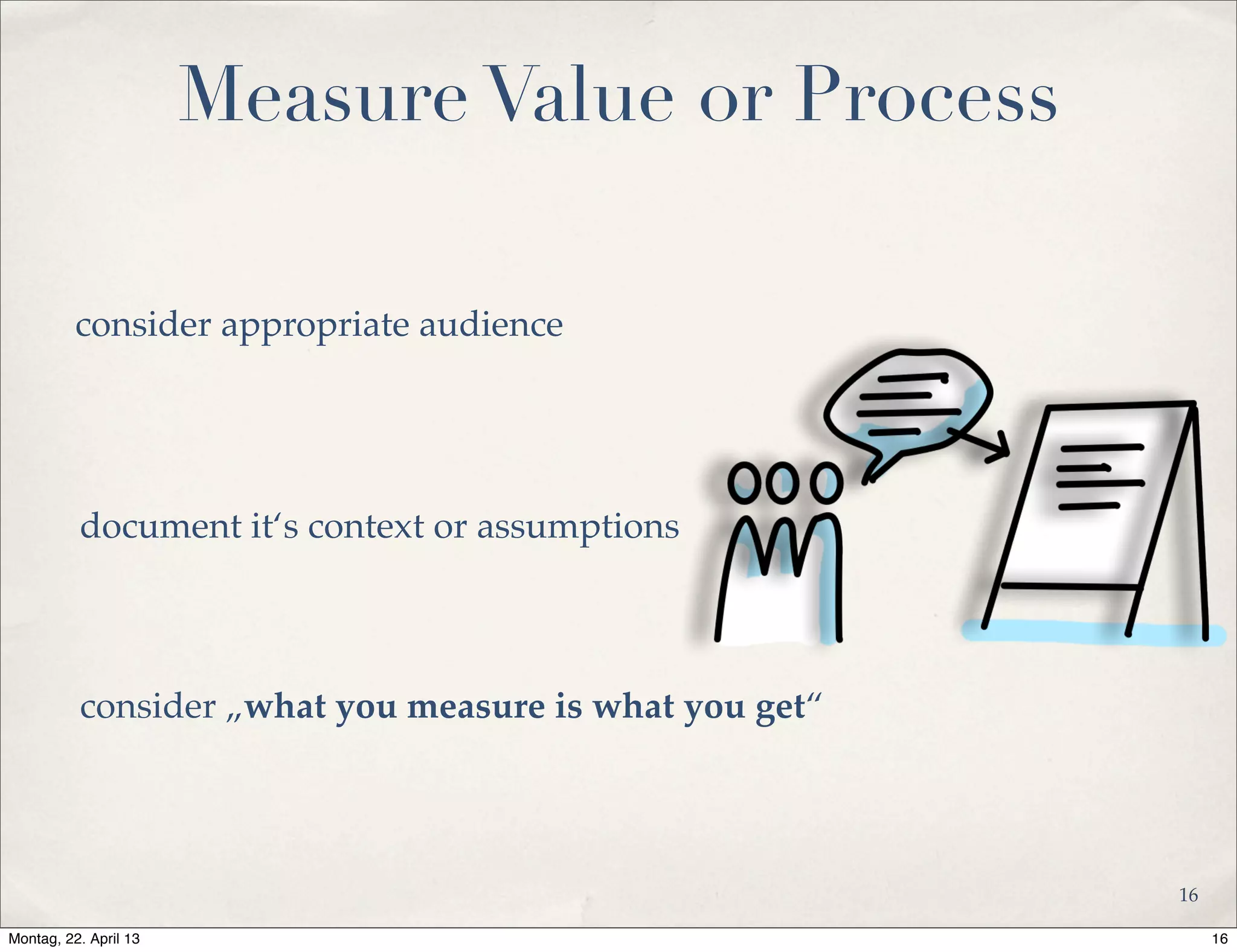

Measure Value or Process
document it‘s context or assumptions
consider appropriate audience
consider „what you measure is what you get“
16
16Montag, 22. April 13
Encourages good enough quality
must come from business owner and not developers
to avoid gold plating
17
17Montag, 22. April 13
Checklist for metrics or
diagnostic
18
18Montag, 22. April 13
Name
this should be well chosen to avoid ambiguity,
confusion, oversimplification.
Question
it should answer a specific, clear question for a particular
role or group. If there are multiple questions, design other
metrics.
Basis of Measurement
clearly state what is being measured, including units.
Labeling of graph axes must be clear rather than brief.
Assumptions
should be identified to ensure clear understanding of
data represented.
Level and usage
indicate intended usages at various levels of the
organization. Indicate limits on usage, if any.
Expected Trend
the designers of the metric should have some idea of
what they expect to see happen. Once the metric is
proven, document common trends
When to use it
what prompted creation or use of this metric? How
has it historically been used?
When to stop using it
when will it outlive its usefulness, become misleading
or extra baggage? Design this in from the start.
How to game it
think through the natural ways people will warp behavior
or information to yield more ‘favorable’ outcomes.
Warnings
recommend balancing metrics, limits on use, and
dangers of improper use 19
19Montag, 22. April 13

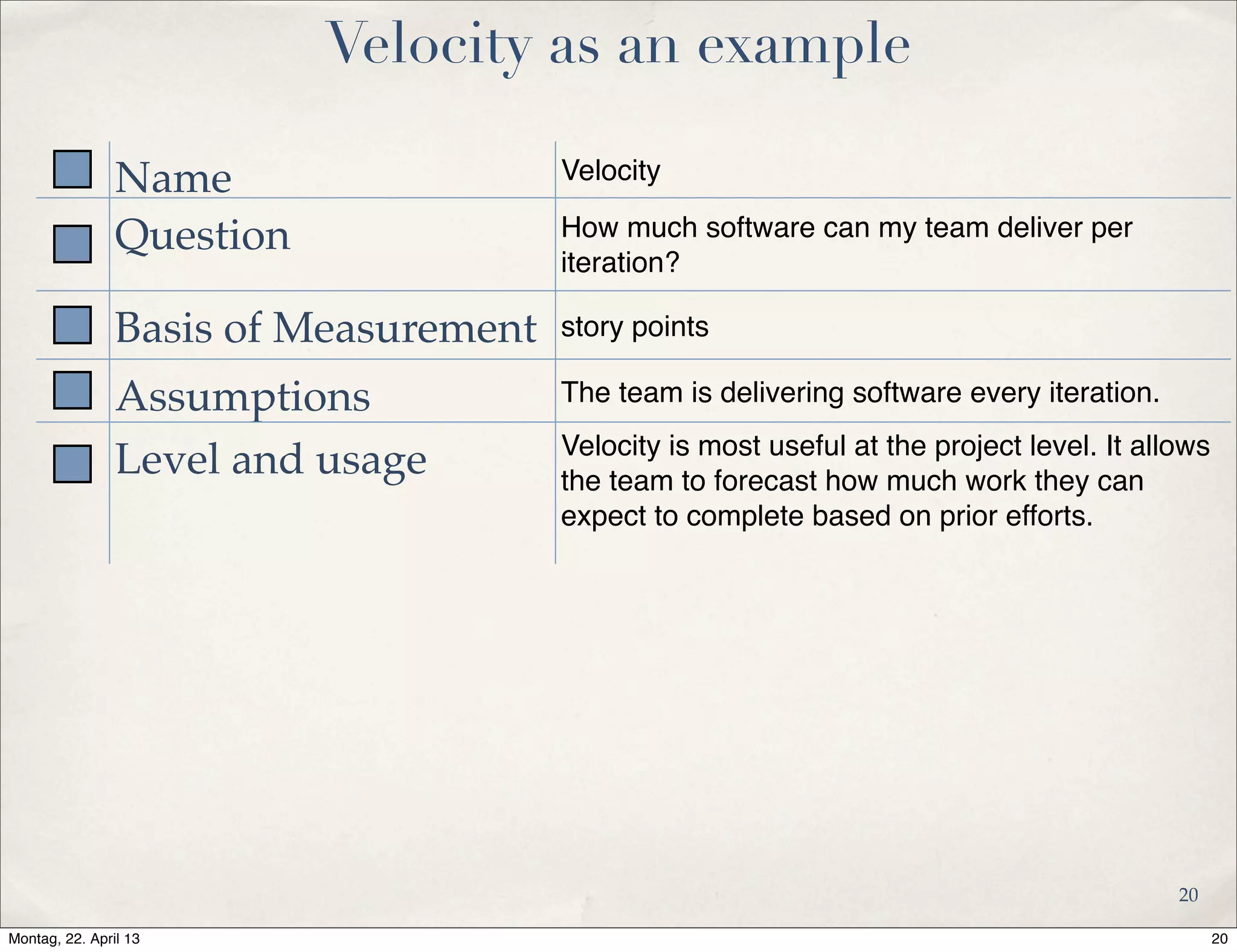

Velocity as an example
Name Velocity
Question How much software can my team deliver per
iteration?
Basis of Measurement story points
Assumptions The team is delivering software every iteration.
Level and usage Velocity is most useful at the project level. It allows
the team to forecast how much work they can
expect to complete based on prior efforts.
20
20Montag, 22. April 13

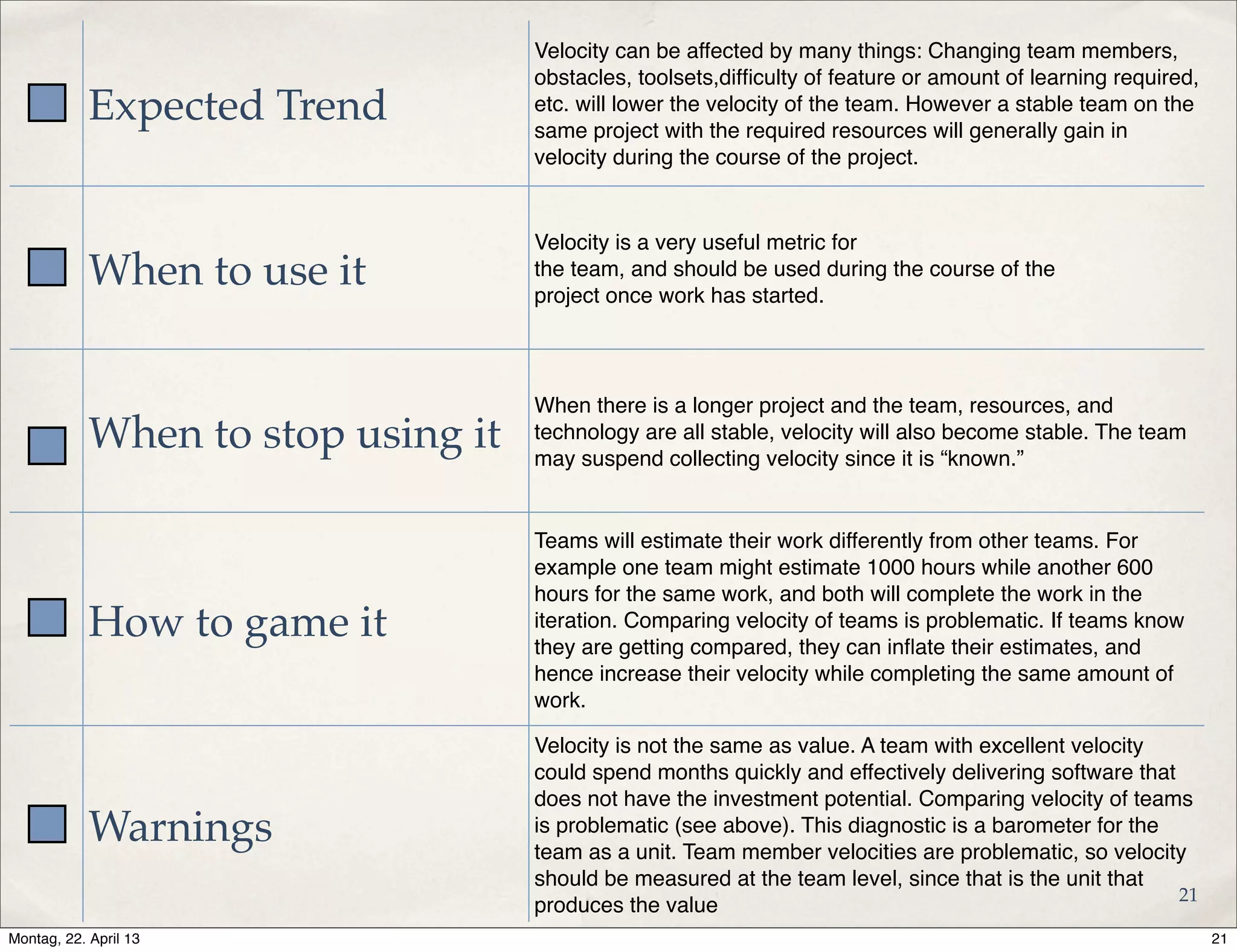

Expected Trend
Velocity can be affected by many things: Changing team members,
obstacles, toolsets,difficulty of feature or amount of learning required,
etc. will lower the velocity of the team. However a stable team on the
same project with the required resources will generally gain in
velocity during the course of the project.
When to use it
Velocity is a very useful metric for
the team, and should be used during the course of the
project once work has started.
When to stop using it
When there is a longer project and the team, resources, and
technology are all stable, velocity will also become stable. The team
may suspend collecting velocity since it is “known.”
How to game it
Teams will estimate their work differently from other teams. For
example one team might estimate 1000 hours while another 600
hours for the same work, and both will complete the work in the
iteration. Comparing velocity of teams is problematic. If teams know
they are getting compared, they can inflate their estimates, and
hence increase their velocity while completing the same amount of
work.
Warnings
Velocity is not the same as value. A team with excellent velocity
could spend months quickly and effectively delivering software that
does not have the investment potential. Comparing velocity of teams
is problematic (see above). This diagnostic is a barometer for the
team as a unit. Team member velocities are problematic, so velocity
should be measured at the team level, since that is the unit that
produces the value
21
21Montag, 22. April 13
Various metrics
22
22Montag, 22. April 13

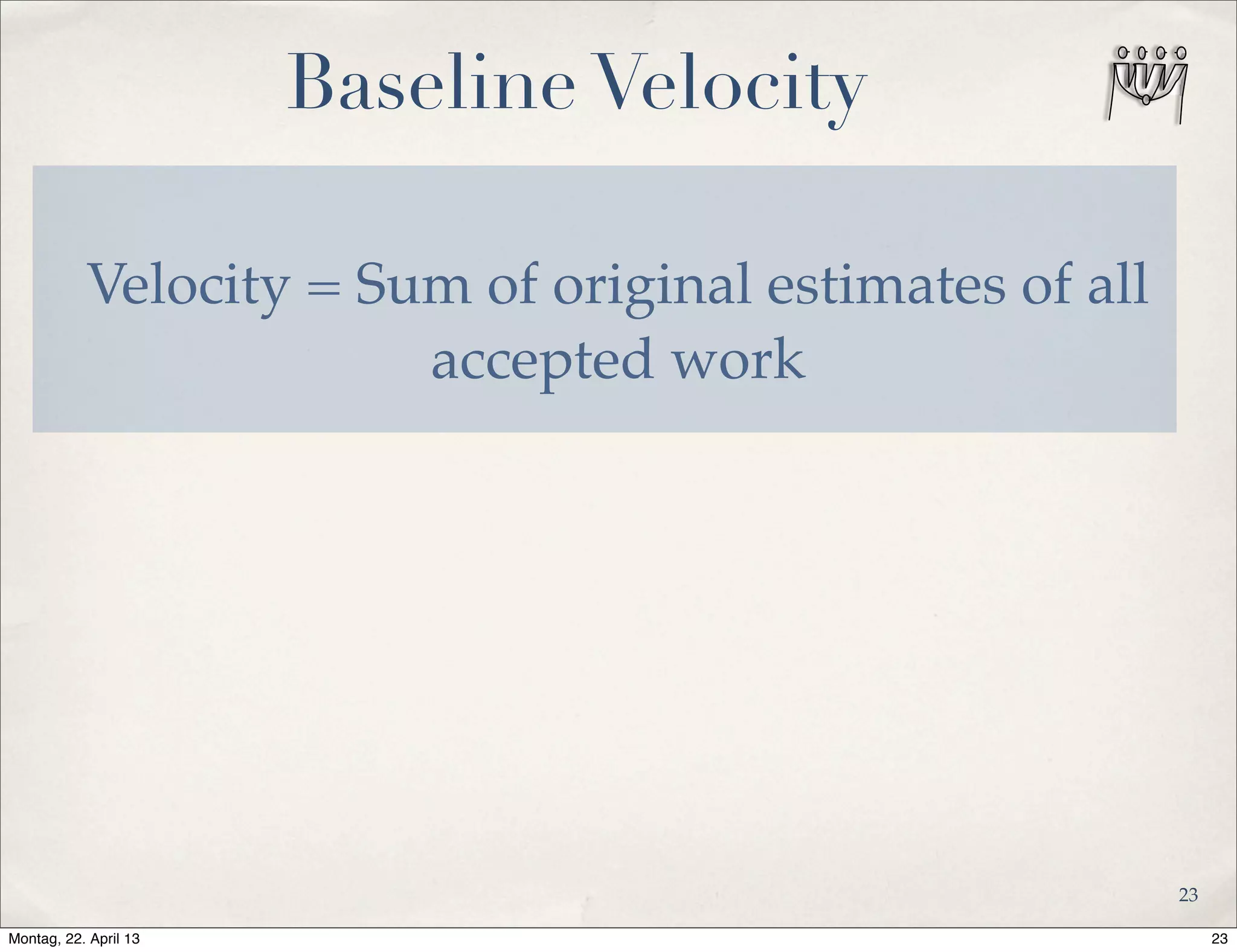

Baseline Velocity
Velocity = Sum of original estimates of all
accepted work
23
23Montag, 22. April 13

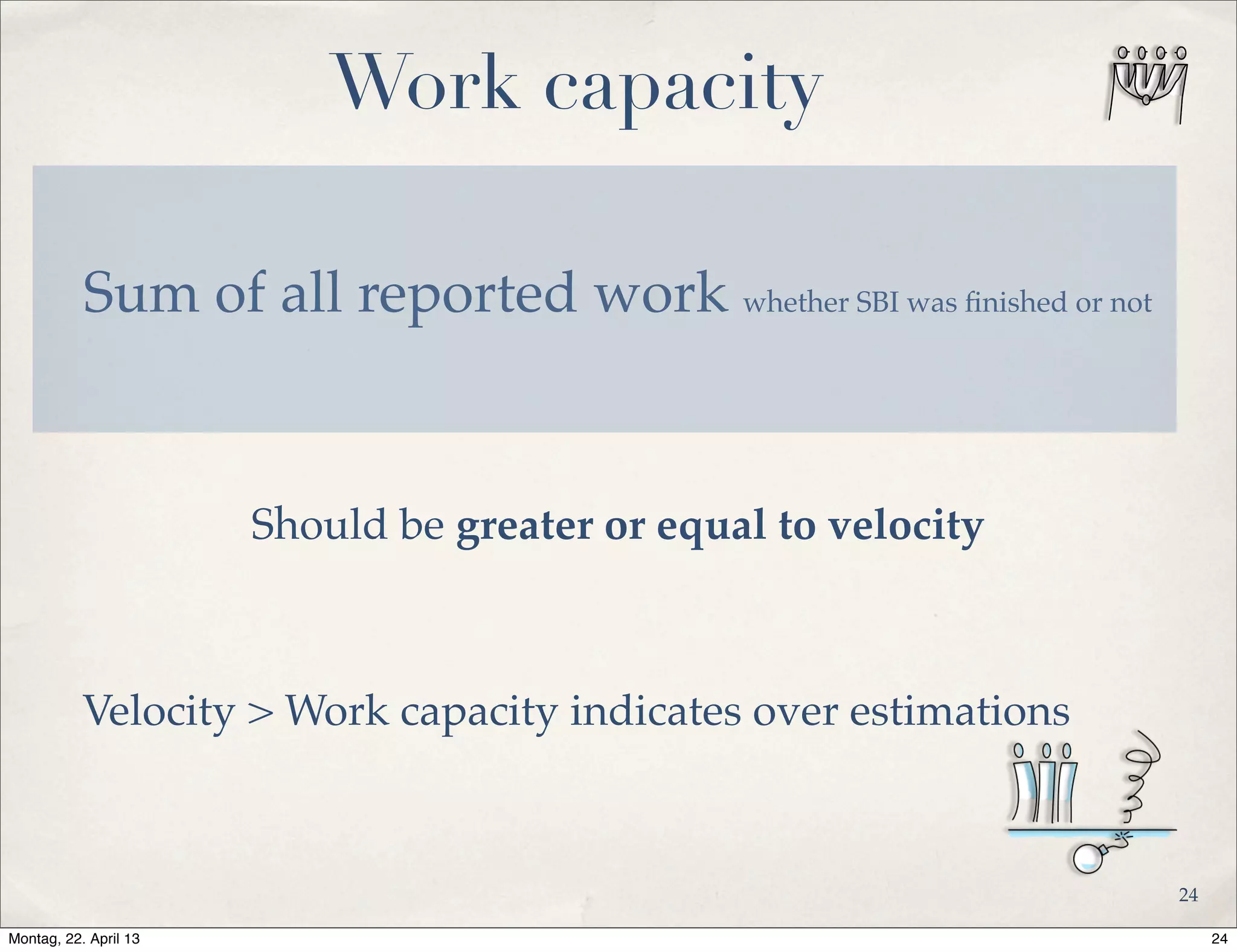

Work capacity
Sum of all reported work whether SBI was finished or not
Velocity > Work capacity indicates over estimations
Should be greater or equal to velocity
24
24Montag, 22. April 13

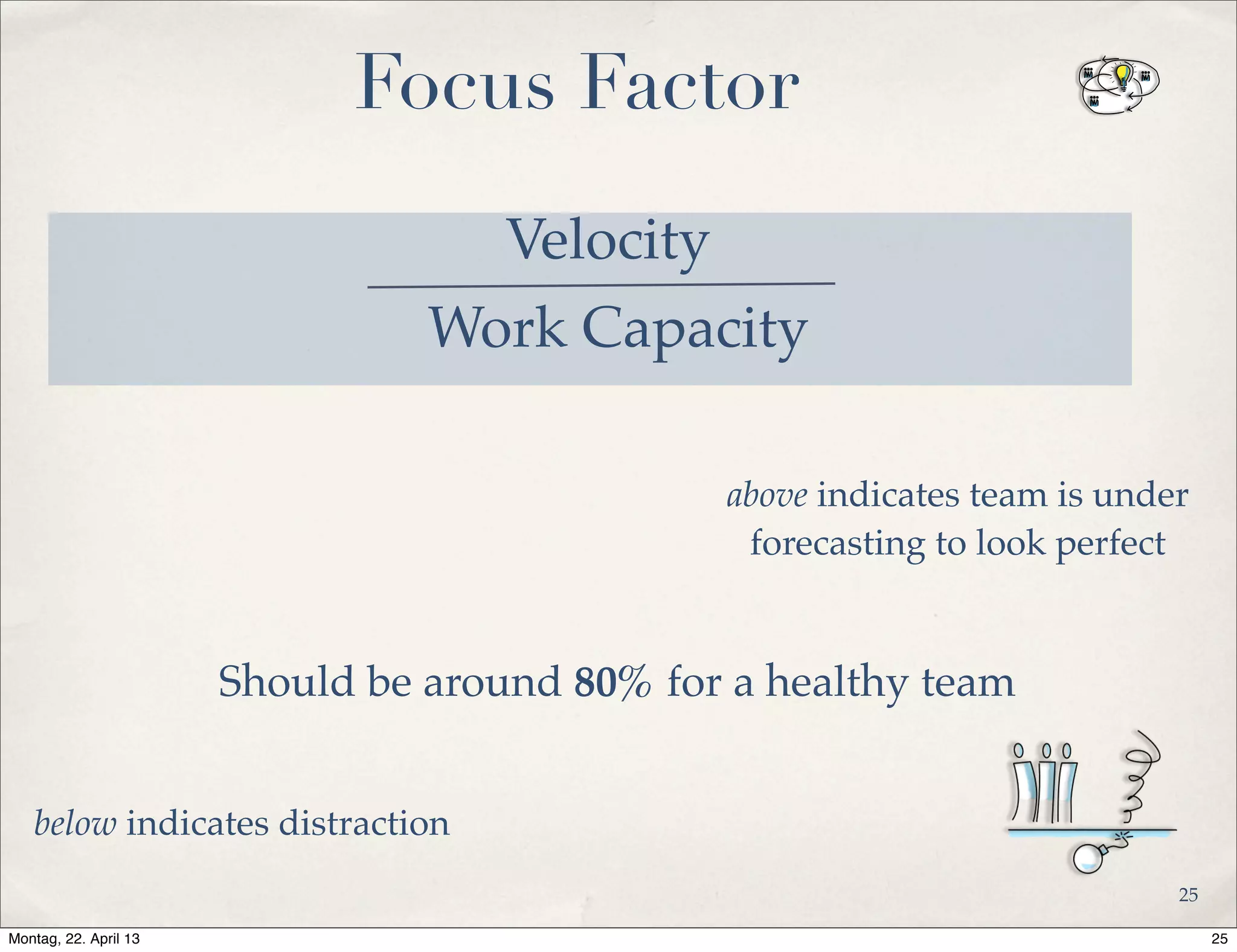

Focus Factor
Velocity
Should be around 80% for a healthy team
below indicates distraction
above indicates team is under
forecasting to look perfect
Work Capacity
25
25Montag, 22. April 13

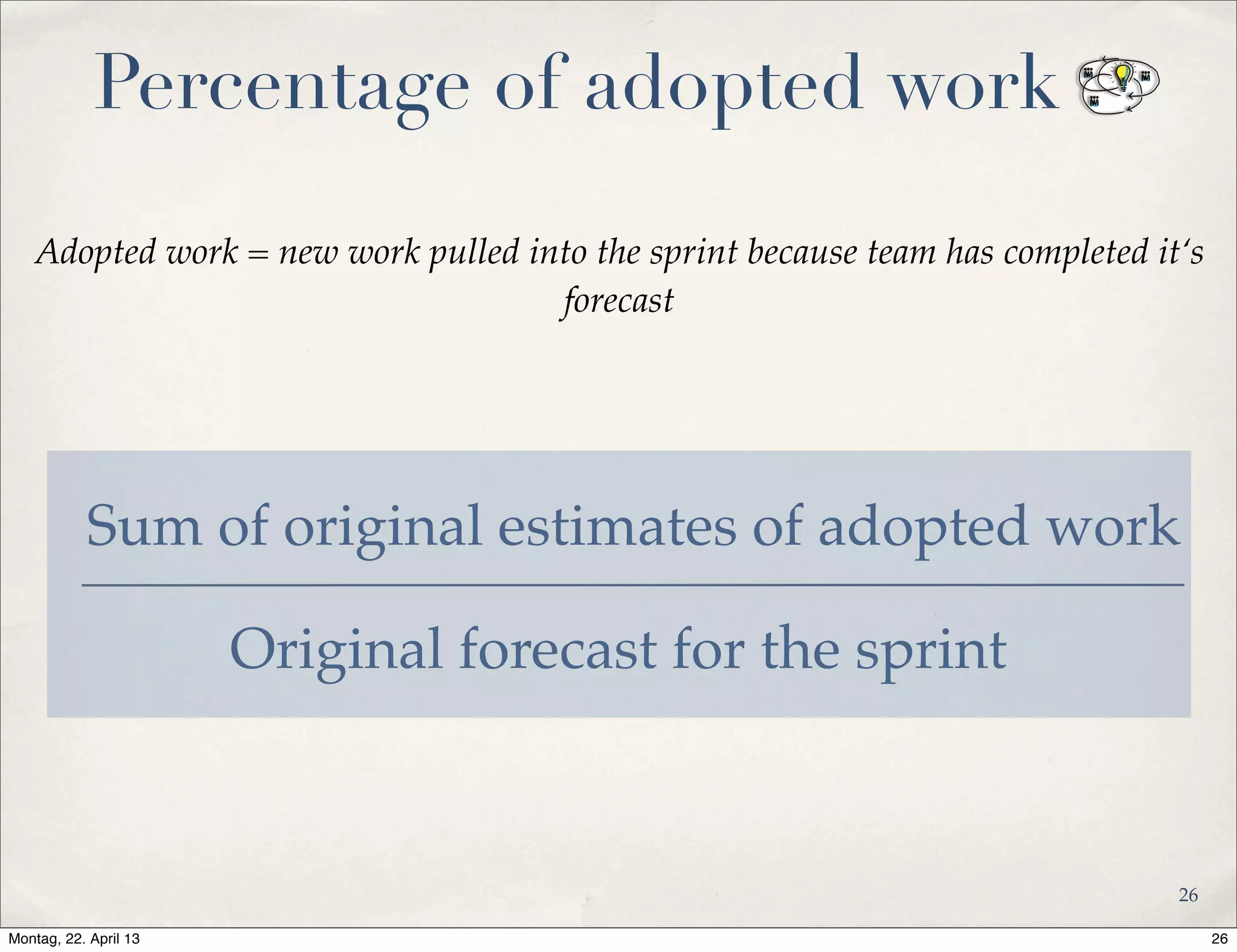

Percentage of adopted work
Sum of original estimates of adopted work
Adopted work = new work pulled into the sprint because team has completed it‘s
forecast
Original forecast for the sprint
26
26Montag, 22. April 13

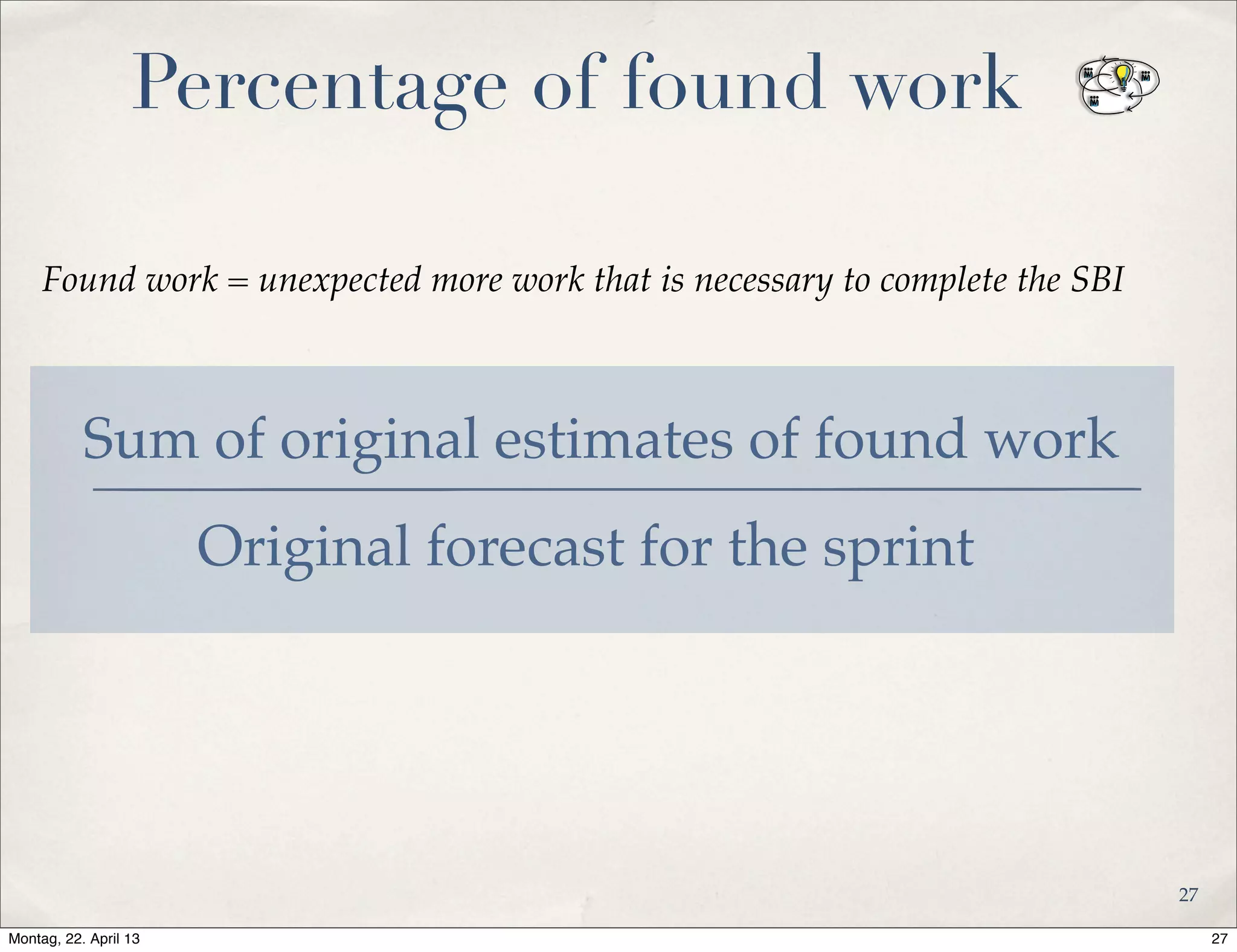

Percentage of found work
Sum of original estimates of found work
Found work = unexpected more work that is necessary to complete the SBI
Original forecast for the sprint
27
27Montag, 22. April 13

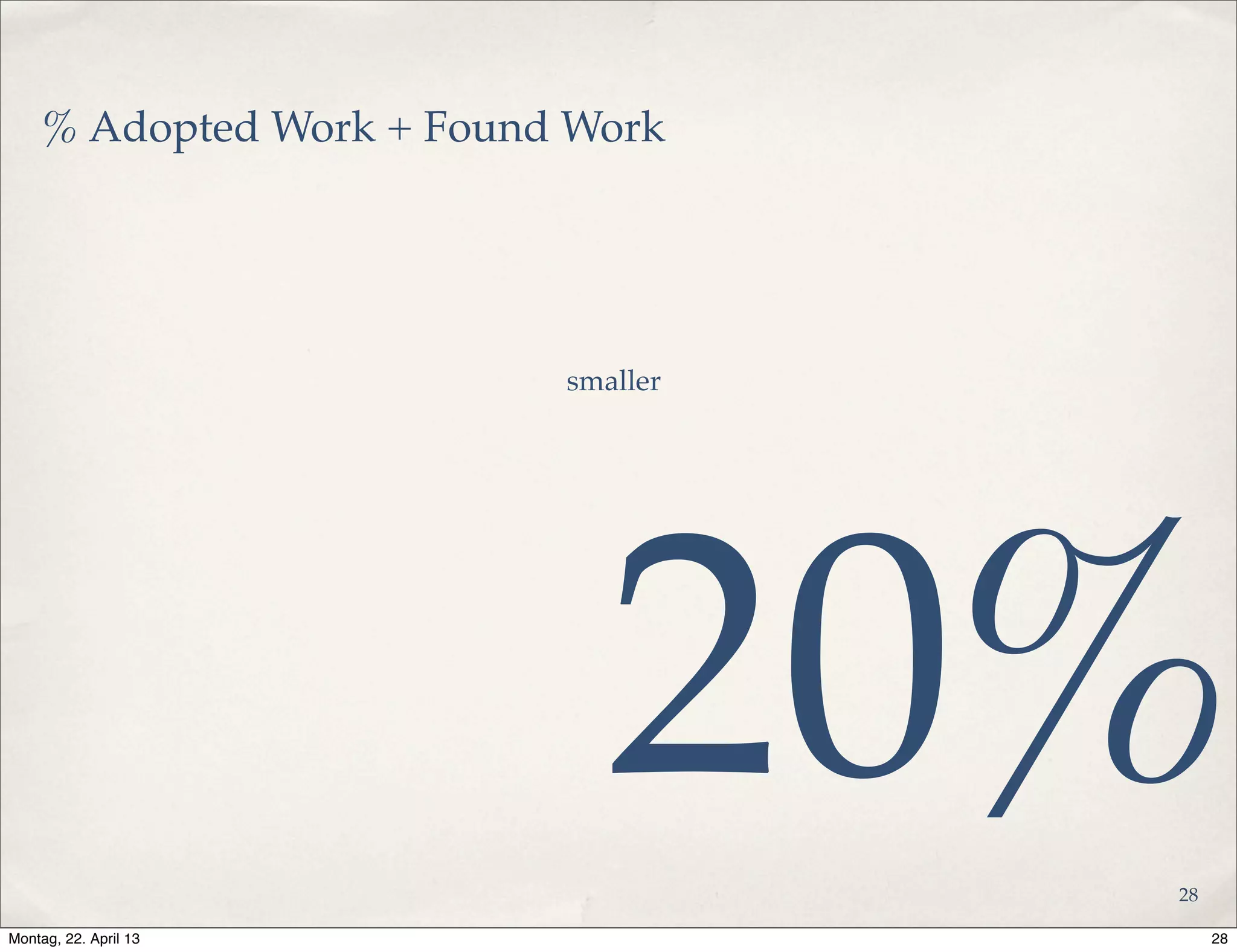

% Adopted Work + Found Work
20%
smaller
28
28Montag, 22. April 13

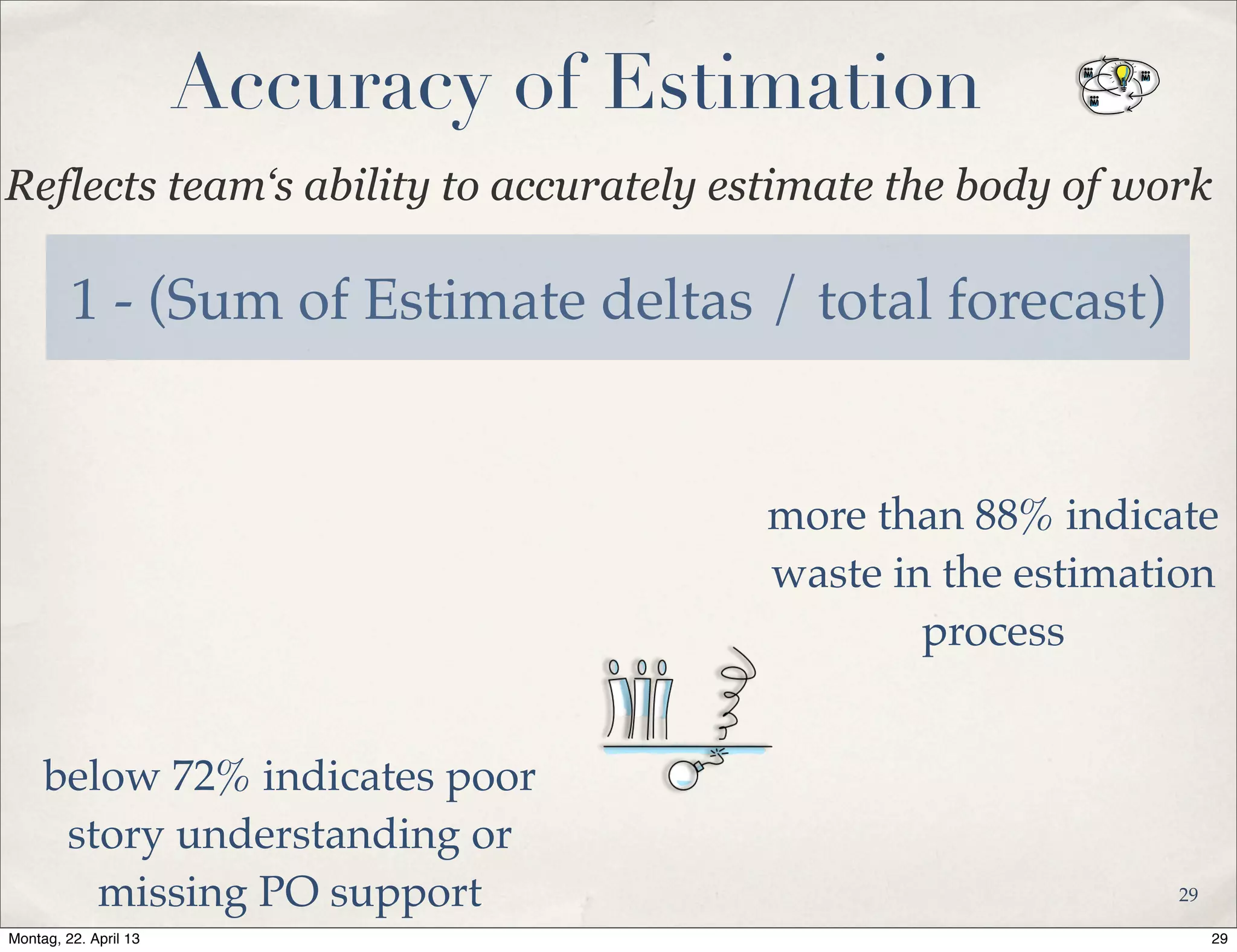

Accuracy of Estimation
1 - (Sum of Estimate deltas / total forecast)
more than 88% indicate
waste in the estimation
process
below 72% indicates poor
story understanding or
missing PO support
Reflects team‘s ability to accurately estimate the body of work
29
29Montag, 22. April 13

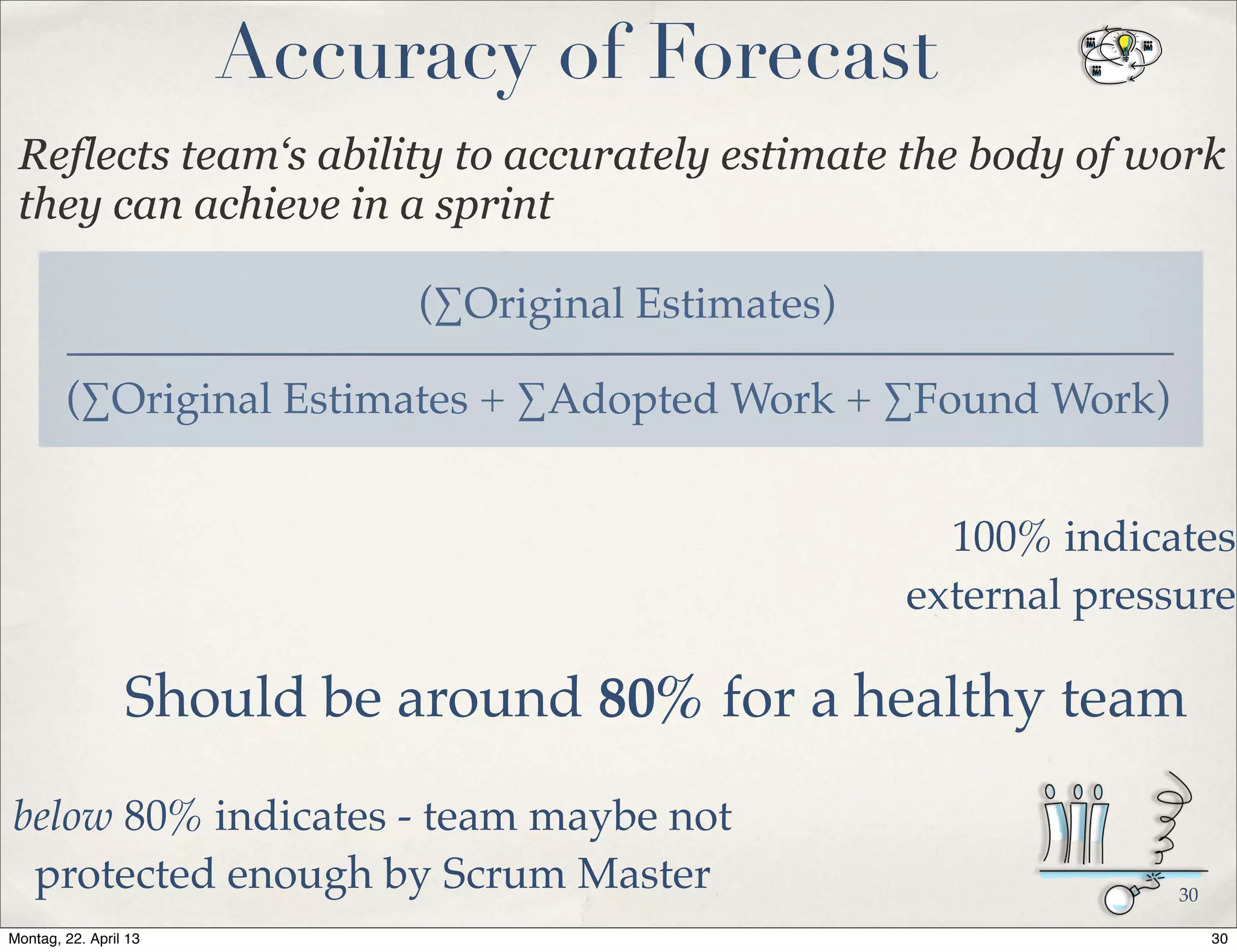

Accuracy of Forecast
(∑Original Estimates)
Should be around 80% for a healthy team
100% indicates
external pressure
below 80% indicates - team maybe not
protected enough by Scrum Master
Reflects team‘s ability to accurately estimate the body of work
they can achieve in a sprint
(∑Original Estimates + ∑Adopted Work + ∑Found Work)
30
30Montag, 22. April 13

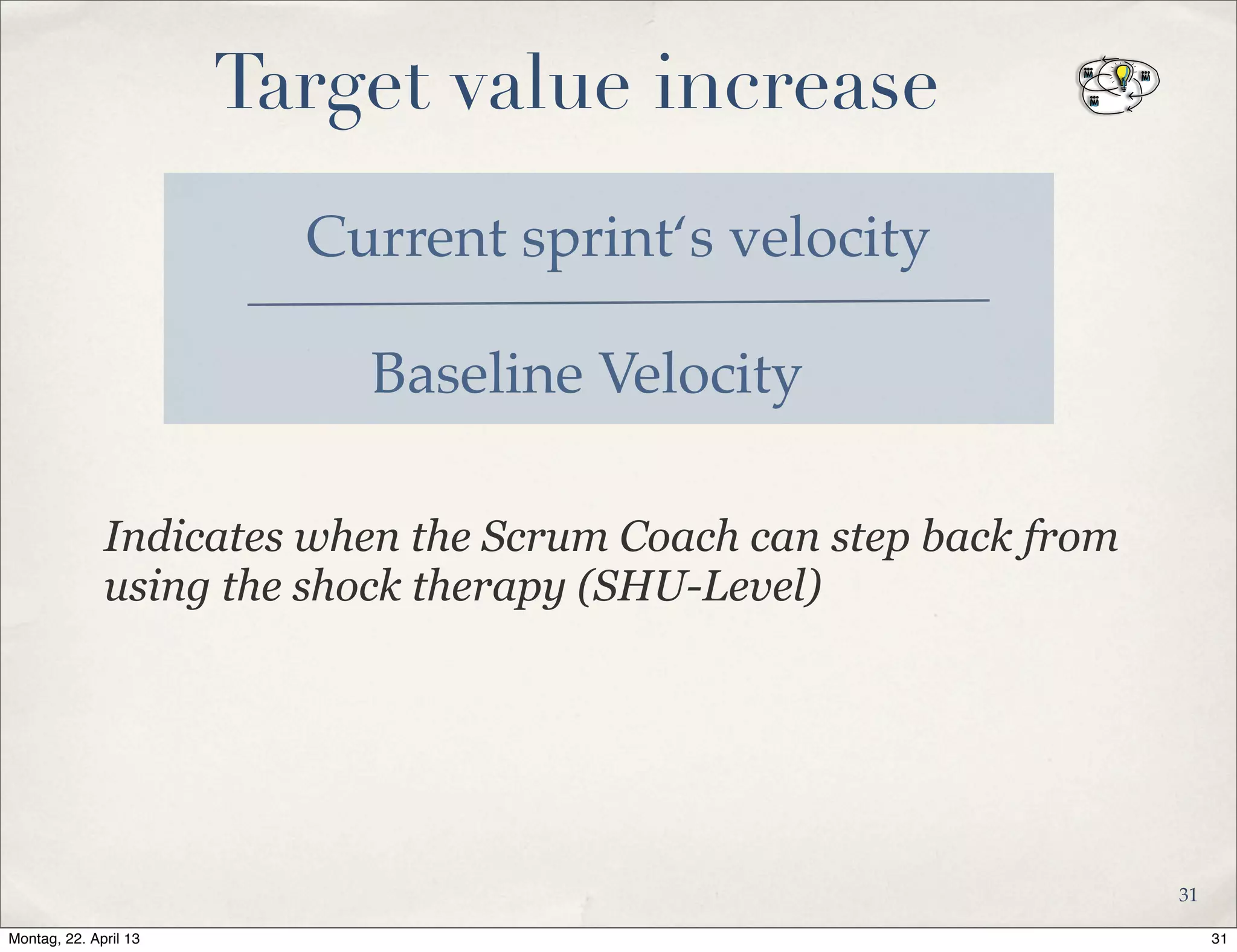

Target value increase
Current sprint‘s velocity
Indicates when the Scrum Coach can step back from
using the shock therapy (SHU-Level)
Baseline Velocity
31
31Montag, 22. April 13

Success at scale
(∑No. Accepted Attempts of scale Fp)
(No. of All Attempts of scale Fp)
Indicates whether a story fits in a sprint
32
32Montag, 22. April 13

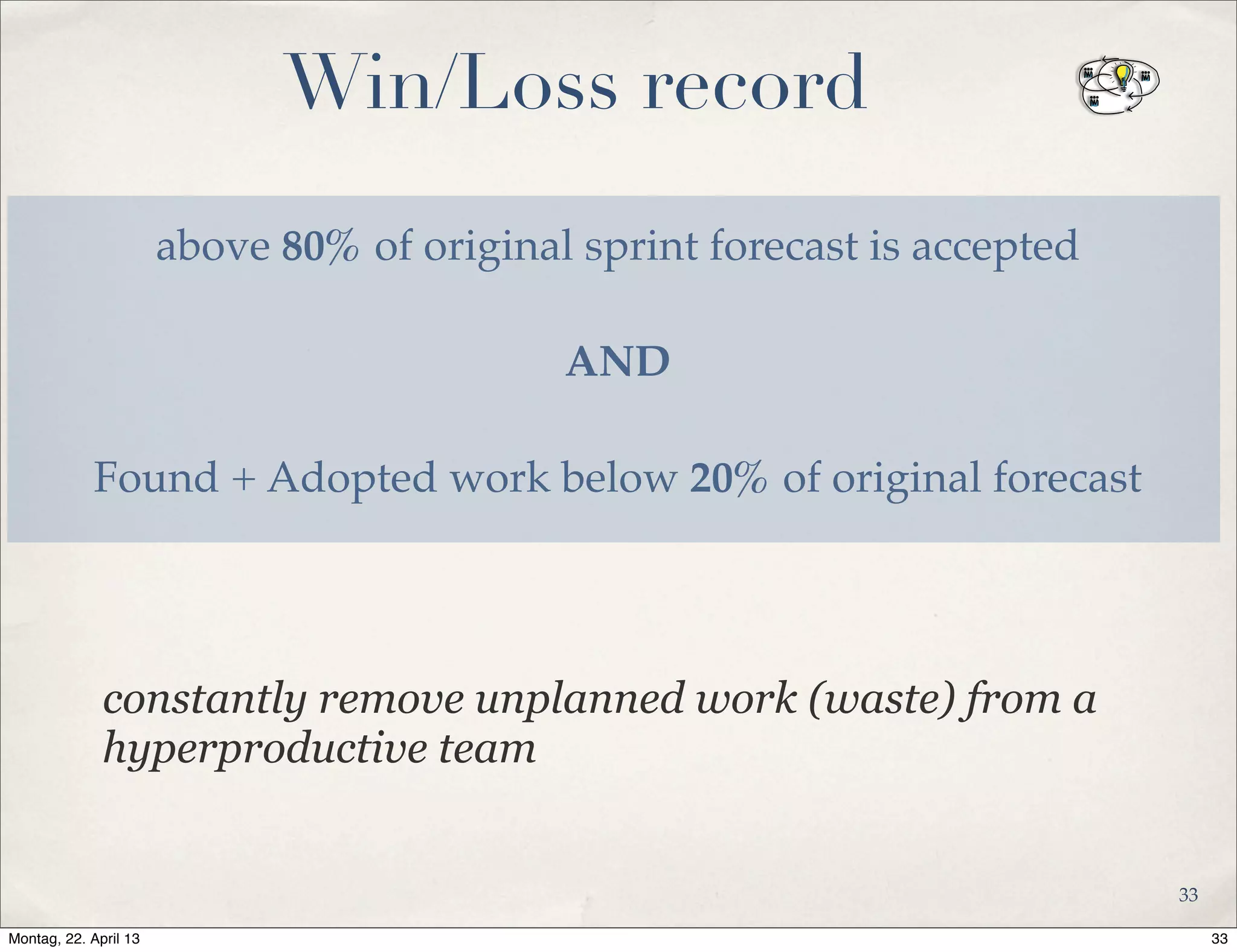

Win/Loss record
above 80% of original sprint forecast is accepted
AND
Found + Adopted work below 20% of original forecast
constantly remove unplanned work (waste) from a
hyperproductive team
33
33Montag, 22. April 13

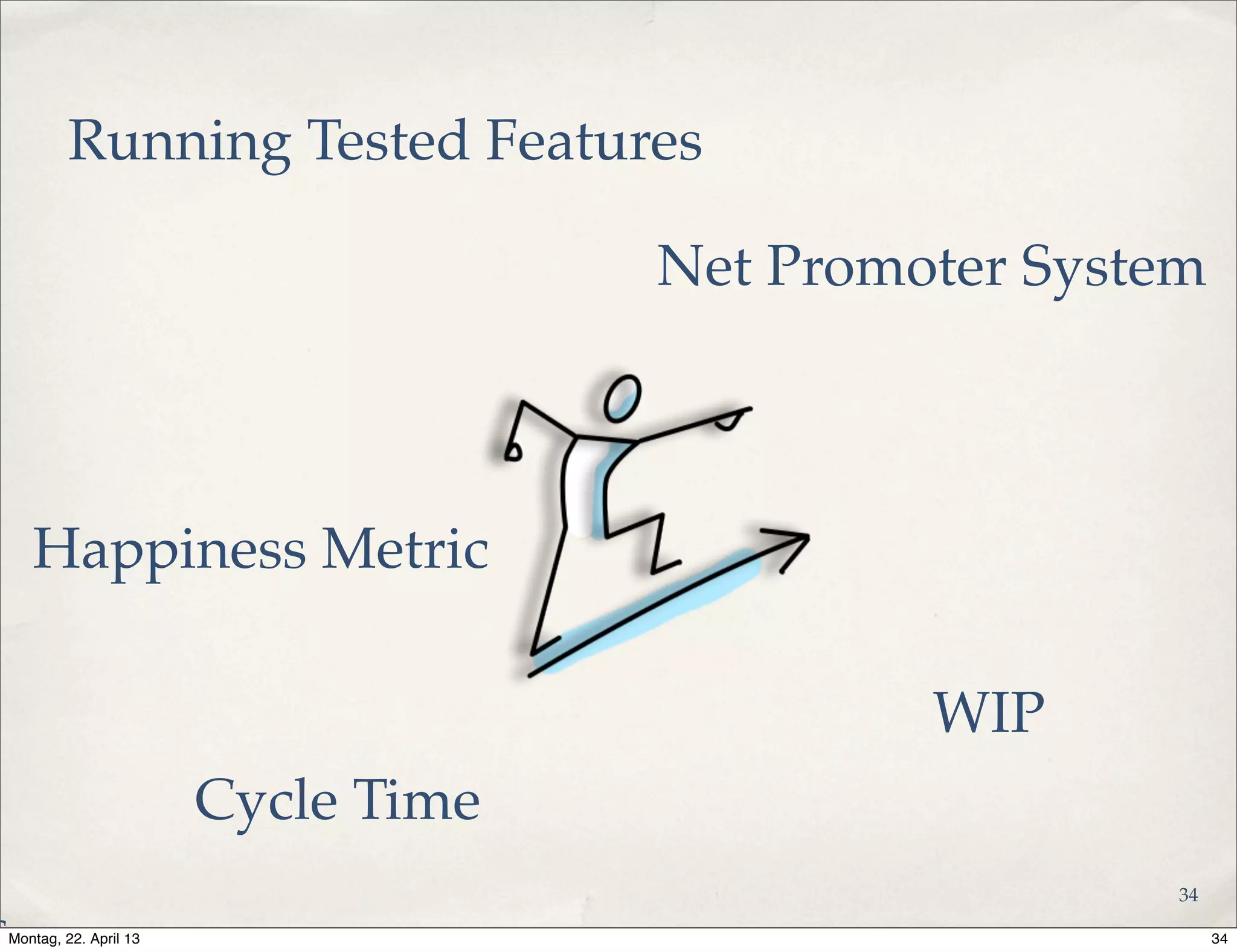

Running Tested Features
Happiness Metric
Cycle Time
c
WIP
Net Promoter System
34
34Montag, 22. April 13
Sources
http://jeffsutherland.com/ScrumMetricsHICSS2013BWSubmissionFinal.pdf
http://martinfowler.com/articles/useOfMetrics.html
http://www.innovel.net/wp-content/uploads/2007/07/
appropriateagilemeasurementagilemetrics.pdf
http://www.leanessays.com/2003/01/measure-up.html
http://www.agileadvice.com/2008/06/15/scrumxplean/measuring-process-
improvements/
http://agile2009.agilealliance.org/files/session_pdfs/Rawsthorne_AgileMetrics_v6d.pdf
35
35Montag, 22. April 13

Agile metrics

  • 1.
    Why metrics What toconsider for agile metrics Various examples 1 1Montag, 22. April 13
  • 2.
  • 3.
    To guide teamstowards hyperproductivity create reference points for changes foster empirical approach fact based and not solely rely on gut feeling visibility and transparency How do we really know it‘s working? 3 3Montag, 22. April 13
  • 4.
  • 5.
    What to considerfor agile metrics VersionOne, Inc. [CC-BY-SA-3.0 (http://creativecommons.org/licenses/by-sa/3.0)], via Wikimedia Commons 5 5Montag, 22. April 13
  • 6.
    Choose a singleeconomic driver as the key metric e.g. Profit per customer visit long term organizational metric set by executive management Use diagnostics as local measurements to support the goal set by teams under specific constraints (length, effort to track,...) e.g. Measurements to improve the „Flow“ of stories What is my one economical driver? 6 6Montag, 22. April 13
  • 7.
    A good agileMetric or Diagnostic ... 7 7Montag, 22. April 13
  • 8.
    Affirms and Reinforces Leanand Agile principles small footprint short tracking periods fosters collaboration 8 8Montag, 22. April 13
  • 9.
    Follows trends notabsolute numbers Measure aggregated data and not on individual level „a team“ „an iteration“ is it the right direction and are we fast enough absolute numbers are artificial and can paralyze why 80% and not 79.5%? 9 9Montag, 22. April 13
  • 10.
    Misleading focus onnumbers Methods must be less than 15lines. You must not have more than 4parameters to a method. Method cyclomatic complexity must not exceed 20. 10 10Montag, 22. April 13
  • 11.
    Extended with purpose Wewould like our code to be less complex and easier to change. Therefore we should aim to write short methods (less than 15 lines) with a low cyclomatic complexity (less than 20 is good). We should also aim to have a small handful of parameters (up to four) so that methods remain as focused as possible. 11 11Montag, 22. April 13
  • 12.
    Measures outcome andnot output The most spectacular outcome can be produced by reducing the planned output while maximizing delivered value 12 12Montag, 22. April 13
  • 13.
    Easy to collect Onebutton automation ... Drawn from operational tools (Backlog, Acceptance Test Suite, Code Analyzers) Easy aggregation and avoidance of management rework 13 13Montag, 22. April 13
  • 14.
    Provides fuel formeaningful conversation It‘s a good sign if people talk about what they‘ve learned to amplify learning and accelerate process improvement 14 14Montag, 22. April 13
  • 15.
    Provides feedback ona frequent and regular basis available in each iteration retrospective and to amplify learning and accelerate process improvement key periodic management meeting 15 15Montag, 22. April 13
  • 16.
    Measure Value orProcess document it‘s context or assumptions consider appropriate audience consider „what you measure is what you get“ 16 16Montag, 22. April 13
  • 17.
    Encourages good enoughquality must come from business owner and not developers to avoid gold plating 17 17Montag, 22. April 13
  • 18.
    Checklist for metricsor diagnostic 18 18Montag, 22. April 13
  • 19.
    Name this should bewell chosen to avoid ambiguity, confusion, oversimplification. Question it should answer a specific, clear question for a particular role or group. If there are multiple questions, design other metrics. Basis of Measurement clearly state what is being measured, including units. Labeling of graph axes must be clear rather than brief. Assumptions should be identified to ensure clear understanding of data represented. Level and usage indicate intended usages at various levels of the organization. Indicate limits on usage, if any. Expected Trend the designers of the metric should have some idea of what they expect to see happen. Once the metric is proven, document common trends When to use it what prompted creation or use of this metric? How has it historically been used? When to stop using it when will it outlive its usefulness, become misleading or extra baggage? Design this in from the start. How to game it think through the natural ways people will warp behavior or information to yield more ‘favorable’ outcomes. Warnings recommend balancing metrics, limits on use, and dangers of improper use 19 19Montag, 22. April 13
  • 20.
    Velocity as anexample Name Velocity Question How much software can my team deliver per iteration? Basis of Measurement story points Assumptions The team is delivering software every iteration. Level and usage Velocity is most useful at the project level. It allows the team to forecast how much work they can expect to complete based on prior efforts. 20 20Montag, 22. April 13
  • 21.
    Expected Trend Velocity canbe affected by many things: Changing team members, obstacles, toolsets,difficulty of feature or amount of learning required, etc. will lower the velocity of the team. However a stable team on the same project with the required resources will generally gain in velocity during the course of the project. When to use it Velocity is a very useful metric for the team, and should be used during the course of the project once work has started. When to stop using it When there is a longer project and the team, resources, and technology are all stable, velocity will also become stable. The team may suspend collecting velocity since it is “known.” How to game it Teams will estimate their work differently from other teams. For example one team might estimate 1000 hours while another 600 hours for the same work, and both will complete the work in the iteration. Comparing velocity of teams is problematic. If teams know they are getting compared, they can inflate their estimates, and hence increase their velocity while completing the same amount of work. Warnings Velocity is not the same as value. A team with excellent velocity could spend months quickly and effectively delivering software that does not have the investment potential. Comparing velocity of teams is problematic (see above). This diagnostic is a barometer for the team as a unit. Team member velocities are problematic, so velocity should be measured at the team level, since that is the unit that produces the value 21 21Montag, 22. April 13
  • 22.
  • 23.
    Baseline Velocity Velocity =Sum of original estimates of all accepted work 23 23Montag, 22. April 13
  • 24.
    Work capacity Sum ofall reported work whether SBI was finished or not Velocity > Work capacity indicates over estimations Should be greater or equal to velocity 24 24Montag, 22. April 13
  • 25.
    Focus Factor Velocity Should bearound 80% for a healthy team below indicates distraction above indicates team is under forecasting to look perfect Work Capacity 25 25Montag, 22. April 13
  • 26.
    Percentage of adoptedwork Sum of original estimates of adopted work Adopted work = new work pulled into the sprint because team has completed it‘s forecast Original forecast for the sprint 26 26Montag, 22. April 13
  • 27.
    Percentage of foundwork Sum of original estimates of found work Found work = unexpected more work that is necessary to complete the SBI Original forecast for the sprint 27 27Montag, 22. April 13
  • 28.
    % Adopted Work+ Found Work 20% smaller 28 28Montag, 22. April 13
  • 29.
    Accuracy of Estimation 1- (Sum of Estimate deltas / total forecast) more than 88% indicate waste in the estimation process below 72% indicates poor story understanding or missing PO support Reflects team‘s ability to accurately estimate the body of work 29 29Montag, 22. April 13
  • 30.
    Accuracy of Forecast (∑OriginalEstimates) Should be around 80% for a healthy team 100% indicates external pressure below 80% indicates - team maybe not protected enough by Scrum Master Reflects team‘s ability to accurately estimate the body of work they can achieve in a sprint (∑Original Estimates + ∑Adopted Work + ∑Found Work) 30 30Montag, 22. April 13
  • 31.
    Target value increase Currentsprint‘s velocity Indicates when the Scrum Coach can step back from using the shock therapy (SHU-Level) Baseline Velocity 31 31Montag, 22. April 13
  • 32.
    Success at scale (∑No.Accepted Attempts of scale Fp) (No. of All Attempts of scale Fp) Indicates whether a story fits in a sprint 32 32Montag, 22. April 13
  • 33.
    Win/Loss record above 80%of original sprint forecast is accepted AND Found + Adopted work below 20% of original forecast constantly remove unplanned work (waste) from a hyperproductive team 33 33Montag, 22. April 13
  • 34.
    Running Tested Features HappinessMetric Cycle Time c WIP Net Promoter System 34 34Montag, 22. April 13
  • 35.
